Waterproofing is Not Below-Grade Roofing
Article by David Campbell, RWC, AIA
Read the full article (PDF)Background on this topic from Inspec
When it comes to keeping water out of a building, roofing and below-grade waterproofing are often misunderstood as interchangeable. However, the differences between them are critical — especially when designing for long-term performance. In this article, we explore why below-grade waterproofing must be treated as a specialized discipline, not just “roofing underground.”
Roofing habits that do not transfer below grade
Roofing and waterproofing get grouped together because both keep water out with a membrane, and because the same project team often buys them on the same page of a specification. On paper the materials can look related. In practice a foundation wall is not a roof turned sideways, and detailing instincts that serve a roof well can produce an assembly that fails quickly once it is covered with soil. The differences are not stylistic. They come from where the assembly sits, what loads it, and whether anyone will ever see it again.
Water arrives under pressure, not by gravity
A roof is a drained assembly. Slope, drains, scuppers and overflows exist so that water leaves under gravity, and a well-detailed roof membrane is rarely asked to hold a standing head of water for long. Below grade that assumption reverses. Where the water table rises above the footing, or where slow-draining soils let water perch against the wall after a storm, the membrane may be asked to resist pressure continuously.
That makes the design head a design input rather than an afterthought. Subsurface information, seasonal groundwater variation, nearby surface water, site grading and the discharge point for the footing drains all belong in the conversation before a product is named. Pressure finds the smallest discontinuity and holds it open, so the drainage strategy — drainage composite, free-draining backfill, functioning drains and a discharge that will still work in ten years — is part of the waterproofing design, not an accessory bought later.
There is no drying side
Roof assemblies get help from the environment. Sun, wind and seasonal reversals give many roofs at least limited drying, and the deck side is usually conditioned space that can be observed. A below-grade wall sits in permanently damp soil at a stable, cool temperature. Wetting is continuous and drying potential toward the soil is essentially zero.
The consequences follow logically:
- Moisture that gets past the membrane tends to stay, migrating through concrete and appearing at the interior some distance from where it entered.
- Interior finishes, insulation, electrical rooms and stored contents face a persistent vapor drive rather than an occasional leak event.
- Materials that tolerate wet-dry cycling on a roof may not tolerate permanent saturation, alkaline concrete, soil chemistry or, on some sites, contaminants and gases in the soil.
Because of that last point, material selection below grade is governed by soil exposure rather than weathering. Sheet membranes, fluid-applied systems, hot rubberized asphalt, bentonite and gel-type products each carry their own substrate, temperature and curing constraints — one family is examined in An Assessment of Polymer Gel Waterproofing. The relevant question is rarely which product is strongest in the abstract, but which one can actually be installed correctly on this substrate, in this weather, by this sequence of trades.
The substrate is a structural element, not a prepared deck
Roof membranes are applied over decks that were selected and prepared as roofing substrates. Foundation walls are structural elements first, and the waterproofing has to accommodate conditions a roofing specification never addresses:
- Cold joints between footing and wall and at construction pours, often with waterstops or keyways that the membrane must coordinate with.
- Form tie holes, honeycombing, fins, and tie-back or soldier-pile penetrations left by the excavation support system.
- Green concrete, form release agents and surfaces that were never floated for adhesion.
- Irregular transitions at footings, pilasters, pipe penetrations, elevator pits, sumps and grade beams.
Each of those is a detail, and details decide how a buried assembly performs. That is true above grade as well — we cover the general principle in Design Issues: The Devil in the Details — but below grade the details are unrecoverable once the hole is closed. Substrate behavior also varies by foundation type; systems that are not cast concrete carry their own constraints, as we discuss in Waterproofing ICF Foundations.
Backfill is the first load the membrane carries

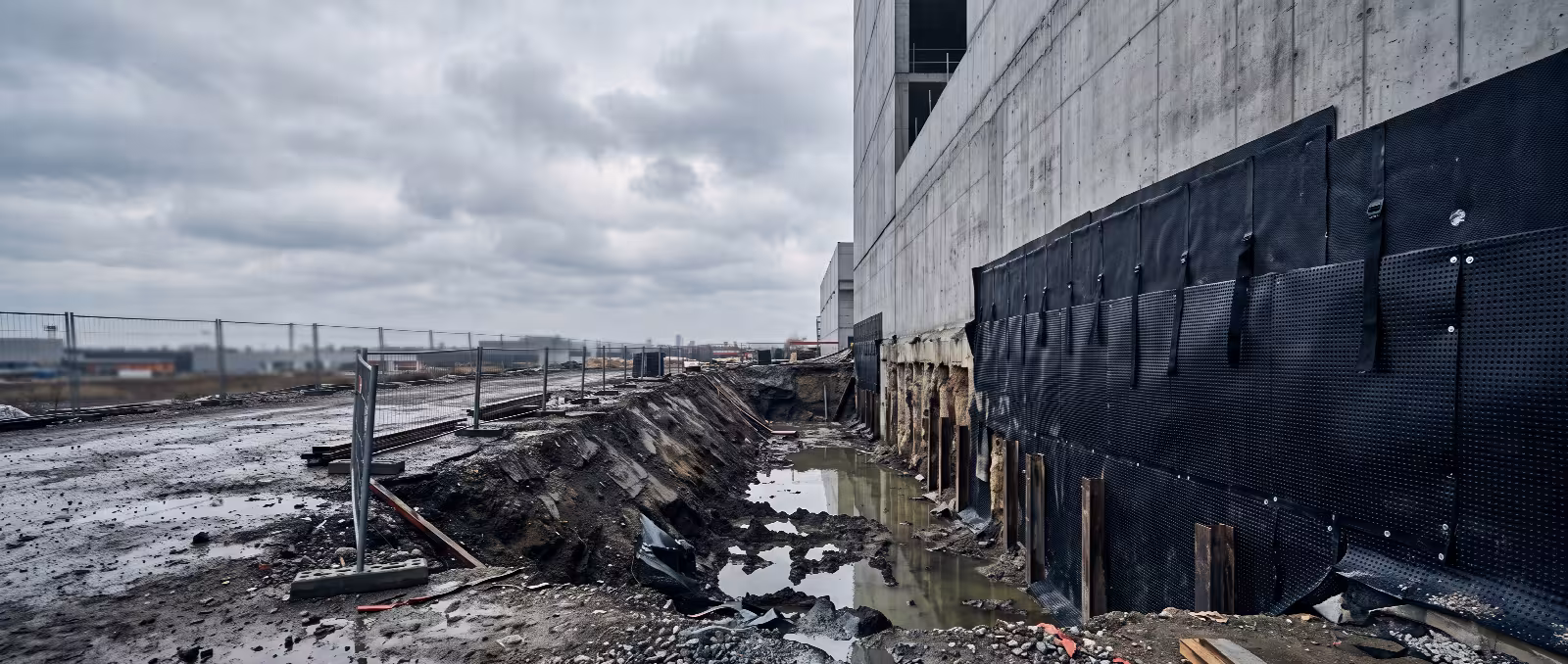

Nothing on a roof is loaded the way a waterproofing membrane is loaded during backfill. Angular stone, dropped debris, compaction equipment and lateral soil pressure all reach the membrane at the moment it is least protected. Protection board, drainage composite, backfill material and lift sequence are therefore waterproofing decisions and belong in the drawings and specifications rather than being left to the contractor's means and methods.
Timing matters as much as material. Membrane installed in freezing conditions, over damp concrete, or ahead of specified cure requirements will not perform simply because the correct product was purchased. A realistic schedule that allows substrate preparation, application and protection in the right order is part of the design, and it is worth defending when the site is under pressure to backfill and move on.
Who owns the transition
Many below-grade problems originate in a scope gap rather than a product failure. The membrane is one subcontractor's work, the air and water barrier above it is another's, the flashing at the grade line may be shown on an architectural detail that neither party priced, and the landscape or paving contractor arrives later to change the grade entirely. Drawings that show each system ending at a line, rather than showing how the two are lapped and sealed together, invite exactly that outcome.
The same gap appears at horizontal buried assemblies — plaza decks, split slabs and podium slabs — where responsibility for slope, drainage at the membrane level, overburden and the protection of the waterproofing often sits with several different trades. Naming the responsible party for every transition in the construction documents does more for long-term performance than upgrading the membrane.
Verification happens once
Roofs can be surveyed over time with infrared, moisture scanning, test cuts and periodic inspection. Below grade, the window for observation closes when backfill starts. Meaningful verification has to be scheduled into the construction sequence: substrate acceptance, mockups of difficult details, review at penetrations and transitions, membrane continuity confirmed before protection and drainage are placed, and a record of what was actually installed. Construction observation is not a formality on this work; it is the only look anyone will get at the water side of the assembly.
That record has value long after the project closes. When water does appear years later, knowing which product went on which wall, where the construction joints fell and how the site was drained turns a guessing exercise into an investigation.
Access is the real cost of a below-grade leak
A roof can be walked, probed and repaired. Most roof repairs are inconvenient; few are site events. Reaching a buried membrane means excavating through landscaping, pavement, utilities and site improvements installed after the waterproofing was covered, often with shoring and restoration costing far more than the original scope.
That economics is why negative-side approaches — injection, crystalline treatment, interior drainage and sump systems — frequently become the practical response, even though they manage water rather than exclude it. It is also why value-engineering decisions that look modest on a bid form deserve scrutiny while the wall is still open.
Read the leak before choosing the fix
Because water travels laterally through soil, drainage layers, cold joints and utility trenches, the point of appearance rarely marks the point of entry. Diagnosis below grade depends on construction sequence, elevations, water source and site history as much as on what the wall looks like from inside — the same discipline described in our article on sourcing leaks. Selecting a remedy before the source is understood usually produces a second repair.
For how we approach investigation, design and observation on buried assemblies, see our below-grade waterproofing page and our broader waterproofing consulting services, or contact us to discuss a specific building.
